Kai Tak development – stages 3B and 5A infrastructure works at former north apron area

Project Number:

7797CL
Attachment 1Attachment 2

Brief Description of Project Scope:

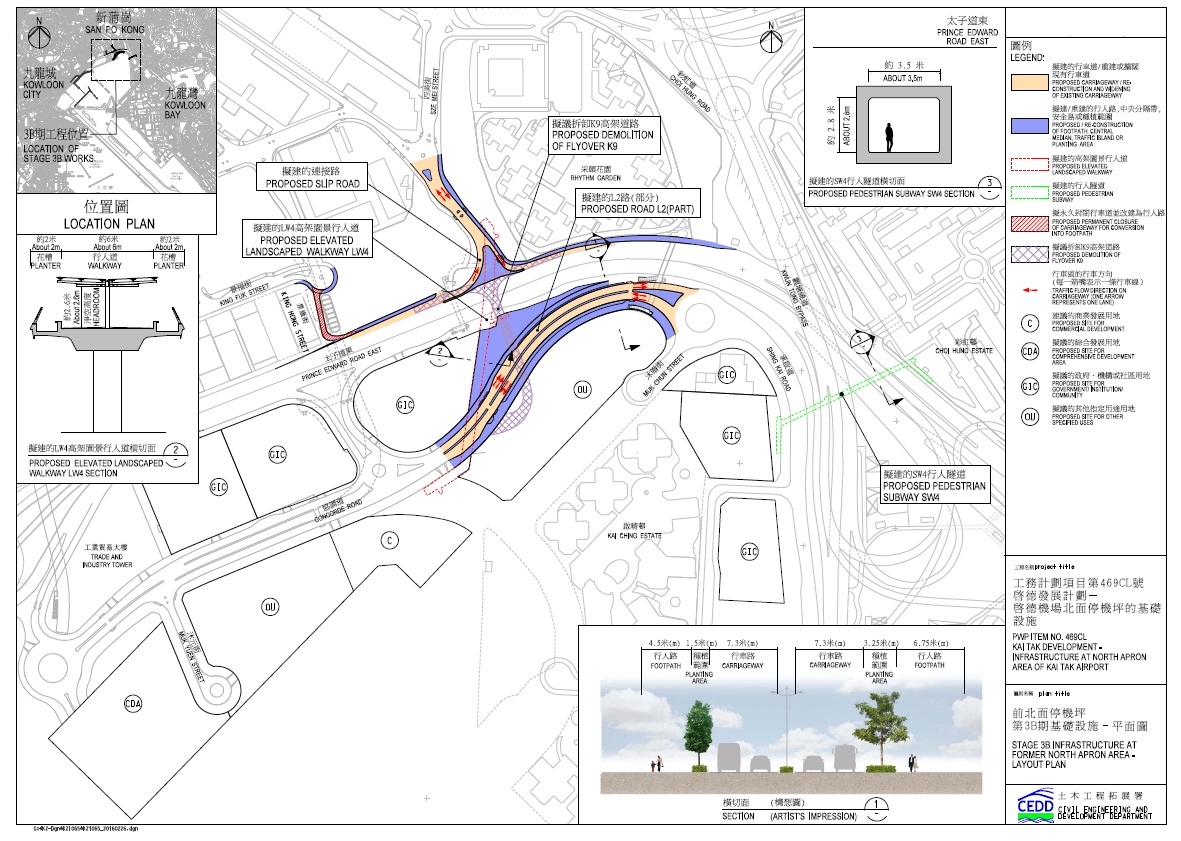

The scope of Stage 3B infrastructure works comprises the following major items:

  1. construction of a section of dual two-lane Road L2 of about 320 metres (m) long connecting Shing Kai Road with Concorde Road, and a pair of single-lane slip roads of about 650 m long linking the eastbound Prince Edward Road East (PERE) with San Po Kong;
  2. construction of an elevated landscaped walkway LW4 of about 290 m long across PERE connecting San Po Kong and Kai Tak Development (KTD);
  3. demolition of existing flyover K9 in San Po Kong across PERE;
  4. construction of a pedestrian subway SW4 of about 180 m long across PERE, Kwun Tong Bypass and Shing Kai Road connecting Choi Hung Estate and KTD;
  5. road modification works in San Po Kong area;
  6. construction of associated footpaths, street lighting, traffic aids, drainage, sewerage, water mains, landscaping and ancillary works; and
  7. implementation of environmental mitigation measures and related environmental monitoring and audit (EM&A) programme.

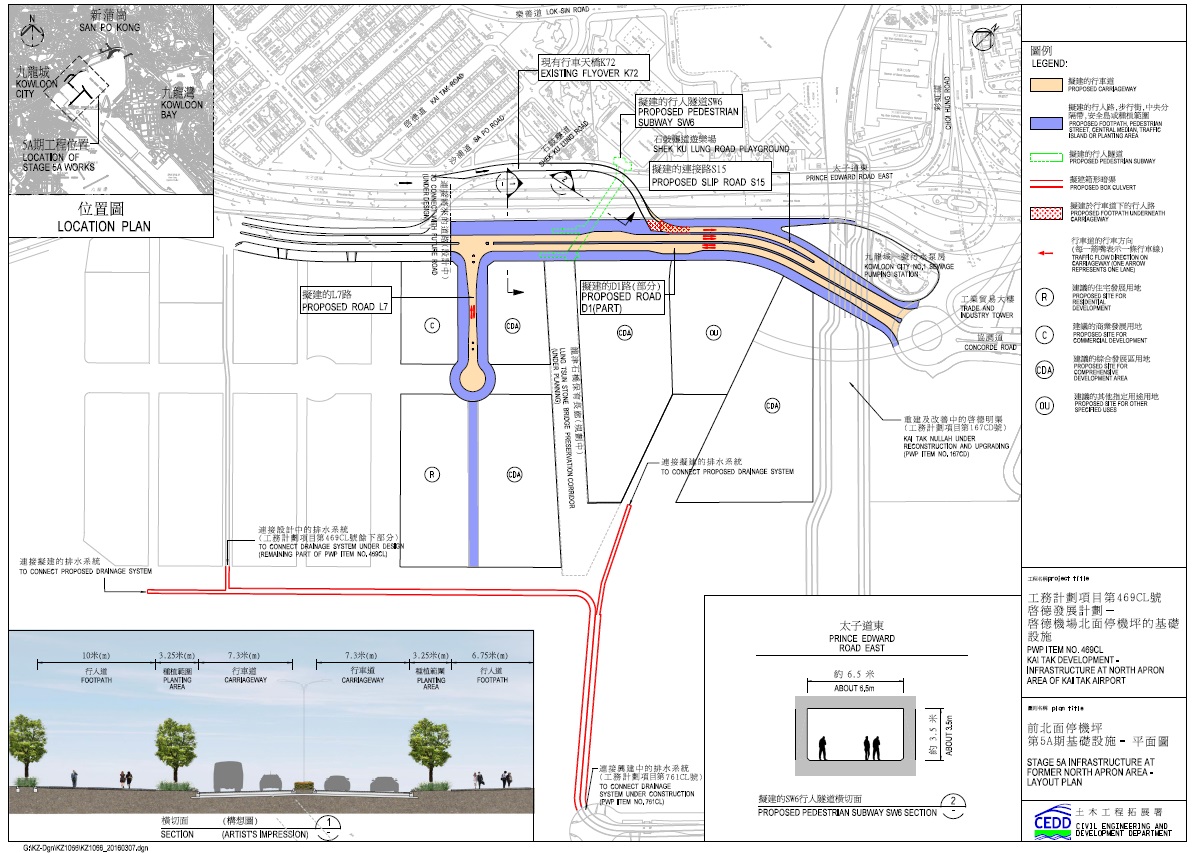

The scope of Stage 5A infrastructure works comprises the following major items:

  1. construction of a single two-lane Road L7 of about 140 m long and a section of dual two-lane Road D1 of about 470 m long connecting with Concorde Road;
  2. construction of a single-lane slip road S15 of about 160 m long linking the proposed Road D1 with existing flyover K72 for connection with PERE eastbound;
  3. construction of a pedestrian subway SW6 of about 120 m long across PERE connecting the future preservation corridor for the Lung Tsun Stone Bridge remnants in KTD and Shek Ku Lung Road Playground;
  4. construction of associated footpaths, street lighting, traffic aids, drainage including about 830 m long box culverts, sewerage, water mains, landscaping and ancillary works; and
  5. implementation of environmental mitigation measures and related EM&A programme.

Project Office in Civil Engineering and Development Department:

East Development Office (Enquiry: 3842 7108)

Consultant:

Ove Arup & Partners Hong Kong Limited and AECOM Asia Company Limited

Approved Project Estimate:

$2.152 billion

Current Progress:

Kai Tak Development - Stage 3B and Stage 5A - infrastructure works at north apron area of Kai Tak Airport commenced on 30 December 2016 and 28 September 2016 respectively and the works are on schedule.

Contract:

Contract No. KL/2015/02

Scope: Same as project scope for the Stage 5A above
Commencement Date: 28 September 2016
Completion Date: End 2020
Contract Sum: $586 million
Contractor: Peako – Wo Hing Joint Venture

Contract No. KL/2015/03

Scope: Same as project scope for the Stage 3B above
Commencement Date: 30 December 2016
Completion Date: End 2020
Contract Sum: $553 million
Contractor: Build King - Richwell Engineering Joint Venture
Back
