Kai Tak development – remaining infrastructure works for developments at the former runway and south apron – landscaped elevated walkway to the New Acute Hospital
Project Number:
7862CLBrief Description of Project Scope:
The scope of the project comprises:

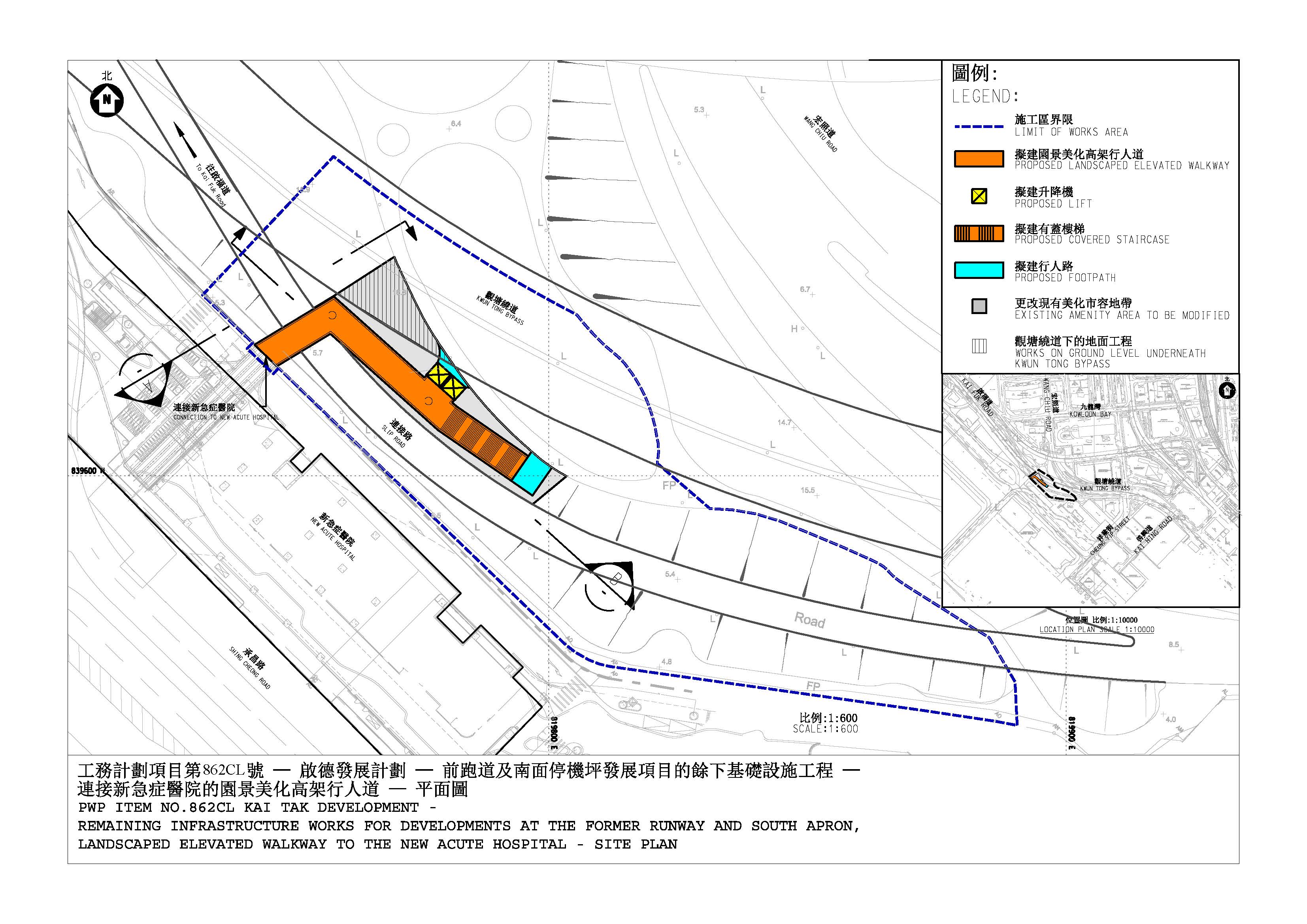

(a) a walkway and a staircase of about 65 m in total length with 2 lifts;
(b) associated footpaths, drainage, landscaping, electrical and mechanical works, and ancillary works.
Project Office in Civil Engineering and Development Department:
East Development Office (Enquiry: 3842 7103)Consultant:
Hyder-Meinhardt Joint VentureApproved Project Estimate:
168.7 millionCurrent Progress:
The works commenced on 28 December 2021. The delivery of works is on schedule.
Contract:
Contract No. ED/2020/04
Contractor:
Po Wing H.P. Drainpipe & Construction Company Limited
